Gabon : Boulevard de la Transition, le chantier des comptes
Libreville, Gabon – The ambitious Boulevard de la Transition project in Libreville is currently progressing on two distinct fronts. While construction crews and heavy machinery are pushing to accelerate work, aiming to deliver initial sections and compensate for delays, a parallel and much more sensitive race is unfolding within government offices. This involves the critical task of ensuring the full traceability and accountability of public funds allocated to the project.
Recent inquiries, including one published on August 23rd, have brought to light concerning financial details. A technical and financial review of the contract reportedly revealed that its initial cost of 8 billion CFA francs inexplicably escalated to 16 billion CFA francs. Furthermore, approximately 3 billion CFA francs were allegedly disbursed to a foreign operator identified as Goran. These allegations, which are pending official judicial confirmation, have positioned this landmark infrastructure project at the heart of serious questions regarding the management of public procurement in Gabon.
The sensitivity surrounding this issue is heightened by the fact that the Boulevard de la Transition is considered one of Libreville’s crucial structural modernization initiatives. Spanning approximately three kilometers, this key road is designed to significantly improve traffic flow within the capital and forms an integral part of a broader urban development plan, which includes the upcoming Administrative City. The project had previously been designated a top governmental priority for the year 2026, underscoring its importance to Gabon’s urban landscape.
Initially envisioned as a tangible symbol of urban transformation, the project now finds itself embroiled in a more fundamental debate for a state committed to establishing a new culture of governance. Key questions arise: How could a public contract’s value double so dramatically? What specific procedures allowed for the disbursements that are now under scrutiny and actively being contested?
The financial file now in the hands of justice
According to information gathered from sources attributed to the Taskforce responsible for the control, audit, and verification of state participations and debt, an estimated three billion CFA francs were reportedly paid to the operator Goran without the prerequisite banking guarantee. The individual in question was subsequently interrogated at the B2 and, according to the same sources, admitted to “serious errors” before reportedly departing Gabonese territory. These sources also confirm that the entire dossier has since been transferred to the public prosecutor for further investigation.
These serious accusations necessitate absolute caution. At this juncture, the publicly available information does not definitively establish that an infraction has occurred, nor does it assign criminal responsibility to any specific individual. It is precisely the role of the ongoing judicial investigation to determine the precise nature of these financial flows, assess the validity of the contractual procedures, identify any potential responsibilities, and clarify the circumstances surrounding the operator’s departure from Gabon.
However, significant institutional questions persist. If the alleged absence of a prior banking guarantee is indeed confirmed, why was this fundamental condition not enforced before the disbursement of funds? If the contract amount genuinely doubled, what specific contractual modifications, administrative validations, and economic justifications account for such a substantial increase?
These interrogations extend beyond the individual case of Goran. They delve into the very operational mechanisms of public procurement, a critical area where administrative decisions, private enterprises, public funding, and economic interests converge.
The urgency of asphalt must not overshadow financial accountability

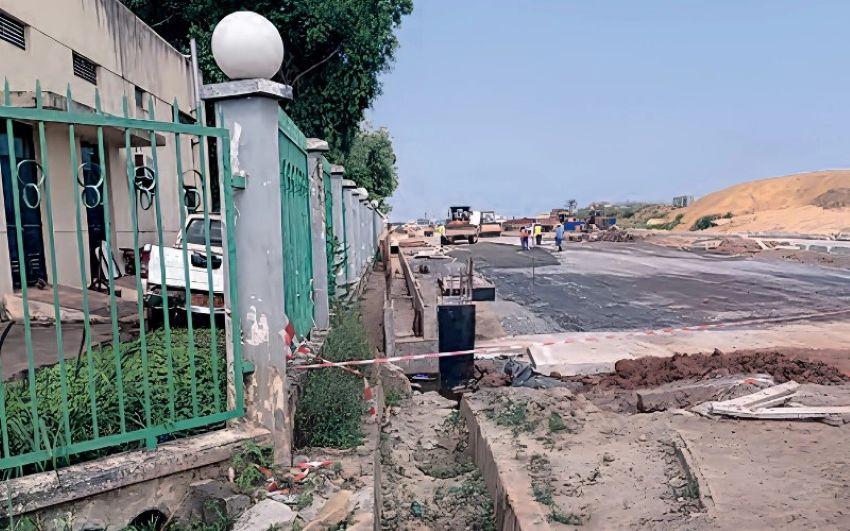

In parallel with the financial investigation, the Taskforce has reportedly intensified its oversight of the construction site. A report dated August 22nd, which has been reviewed, specifically calls for the swift procurement of materials, an enhancement of logistical resources, and the resumption of night work. During a meeting held on August 20th, a presidential directive set an objective to bring the section between PK0+240 and PK0+800 to the impregnation phase by September 1st, highlighting the government’s commitment to rapid completion.
This accelerated resumption of work aligns with the project’s vital urban development objectives. Yet, it also raises important governance considerations. While the State legitimately seeks to rapidly complete infrastructure that residents eagerly await, it must equally safeguard evidence, thoroughly document contracts, and establish accountability for any anomalies uncovered during audits. This delicate balance is crucial for maintaining public trust in Gabon’s development initiatives.
The paradox of the Boulevard de la Transition lies precisely here: as the physical construction becomes more visible, the demand for financial transparency must simultaneously escalate. The public expects not only to witness the progress of asphalt laying but also to fully comprehend the project’s true cost, the rationale behind that expenditure, and the precise rules governing contract awards and execution.
This demand for accountability is particularly strong given that the Gabonese government has previously encountered financial and social challenges associated with major urban works. In 2025, for instance, the Council of Ministers approved a waste management plan specifically for debris generated by Libreville’s modernization efforts, including those related to the Boulevard de la Transition. Furthermore, the project for relocating affected populations received support from the BDEAC, indicating prior complexities in large-scale urban development.
Therefore, this dossier must be rigorously pursued along two parallel and inseparable tracks. The first involves the effective delivery and completion of the infrastructure itself. The second concerns establishing the complete financial truth behind the contract. The success of one cannot, and must not, compensate for the failure of the other.
The Boulevard de la Transition should not merely become a symbol of a construction site measured solely by kilometers of road built. Instead, it must serve as an opportunity to demonstrate that a public investment can be meticulously controlled from its initial signing through to the expenditure of the very last franc. If the alleged anomalies are confirmed, accountability must be established, and any resulting damages repaired. Conversely, if no wrongdoing is found, the justice system must clearly state this. In either scenario, the true ‘transition’ that citizens have long demanded involves making public funds traceable, justifiable, and verifiable expenditures, fostering greater trust in Gabon’s governance.
